TABLE OF CONTENTS
Construction Activities
undertaken during the Reporting Month
Statues of Environmental Licensing
and Permitting
Monitoring Parameters,
Frequency and Duration
Monitoring Methodology and
QA/QC Procedure
Monitoring Parameters,
Frequency and Duration
Monitoring Methodology and
QA/QC Procedure
Implementation Status of
Environmental Mitigation Measures
Implementation Status of
Event and Action Plans
Summary of Complaint,
Warning, Notification of any Summons and Successful Prosecution
Monitoring Schedule for
Next Month
lIST OF TABLES
Table I............... Summary
of Complaint/Summons/Prosecution in the Reporting Month
Table
1.1............ Key
Project Contacts
Table
1.2............ Summary
of Environmental Licensing and Permit Status
Table
2.1 ........... Locations
for Air Quality Monitoring
Table
2.2 ........... Air
Quality Monitoring Equipment
Table
2.3 ........... Impact
Dust Monitoring Parameters, Frequency and Duration
Table
3.1 ........... Noise
Monitoring Stations
Table
3.2 ........... Noise
Monitoring Equipment
Table
3.3 ........... Noise
Monitoring Parameters, Frequency and Duration
Table
3.4 ........... Baseline
Noise Level and Noise Limit Level for Monitoring Stations
Table
4.1............ Quantities
of Waste Generated from the Project
Table
6.1............ Observations
and Recommendations of Site Inspections
Table
6.2............ Status
of Required Submission under Environmental Permit
lIST OF FIGUREs
Figure 2 Project Organisation for
Environmental Monitoring and Audit
Figure 3 Location
of Monitoring Station
lIST OF APPENDIces
Appendix A Action and Limit Levels for Air Quality and Noise
Appendix B Copies of Calibration Certificates
Appendix C Weather Information
Appendix D Environmental Monitoring Schedules
Appendix E 1-hour TSP Monitoring Results and Graphical Presentations
Appendix F 24-hour TSP Monitoring Results and Graphical Presentations
Appendix G Noise Monitoring Results and Graphical Presentations
Appendix H Summary of Exceedance
Appendix J Environmental Mitigation Implementation Schedule (EMIS)
Appendix L Summary of Waste Generation and Disposal Records
Appendix M Construction Programme
Introduction

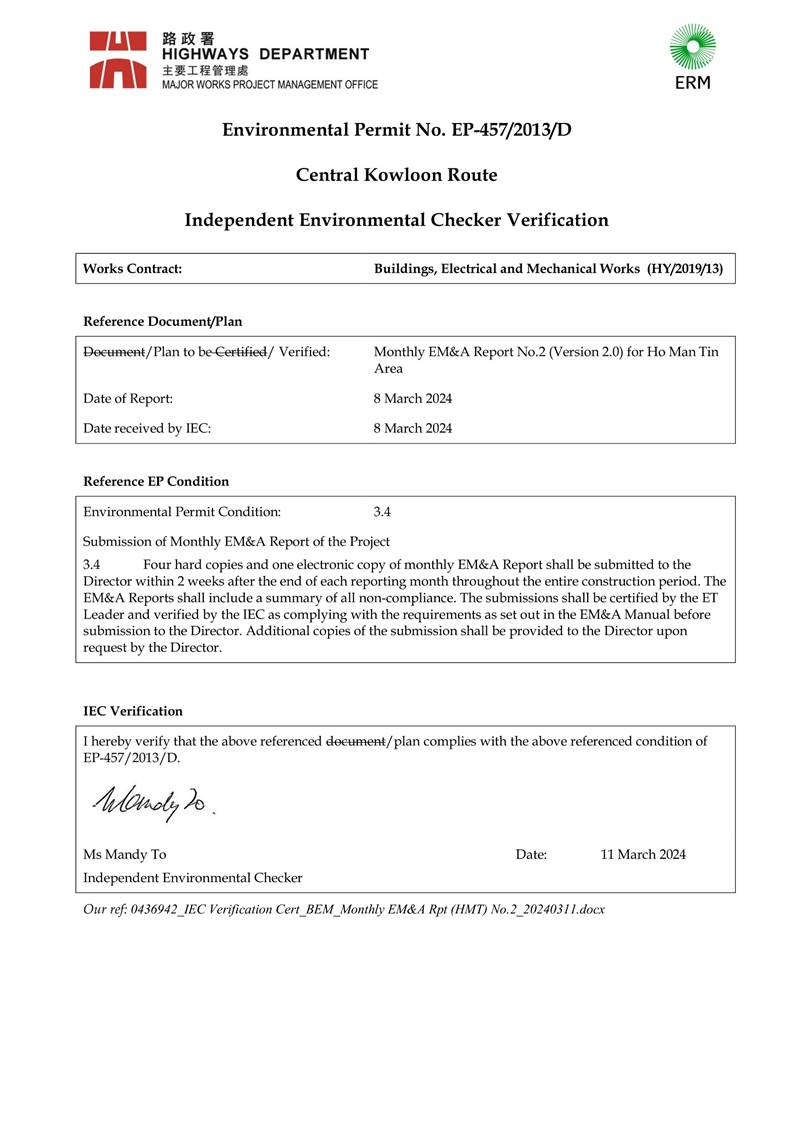

1. This is the 2nd Monthly Environmental Monitoring and Audit (EM&A) Report prepared by the Environmental Team (ET), Cinotech Consultants Ltd., for Contract No. HY/2019/13 “Central Kowloon Route – Buildings, Electrical and Mechanical Works”. This report summarized the monitoring results and audit findings of the EM&A programme under the issued EP No. EP-457/2013/D, and in accordance with the EM&A programme in Central Tunnel (Ho Man Tin Area) during the reporting period from 1st February 2024 – 29th February 2024.
2. The major site activities undertaken in Central Tunnel (Ho Man Tin Area) in the reporting month included:
Environmental
Monitoring Works
3. Environmental monitoring for the Project was performed in accordance with the EM&A Manual and the monitoring results were checked and reviewed. Joint weekly site inspections with the representative of ET, Engineer Representative and the Contractor for for Contract No. HY/2019/13 were conducted on 7, 14, 20, 27 February 2024, whereas joint site inspection with the representative of IEC was conducted on 27 February 2024. The implementation of the environmental mitigation measures, Event and Action Plans and environmental complaint handling procedures were also checked.
4.
A summary of the non-compliance (exceedance) during the reporting month (February 2024) and the investigation results and/or follow-up actions
is provided below:
Complaint Handling, Prosecution and Public Engagement
5.
Summary of complaint/summons/prosecution in the
reporting month is tabulated in Table I.
Event |
Event Details |
Follow-up/ Remedial Actions |
Status/ Remarks |
|
Number |
Brief Description |
|||
Complaints
Received |
1 |
A
complaint was received from 1823 on 7 Feb 2024 regarding noise nuisance
caused by mechanical equipment at the construction site near Chung Hau St.
and Fat Kwong St. after 7 pm. |
Enhance mitigation measures including installation
for noise barrier, and closely monitoring the noise source. |
EPD and HyD have no further
comment. The complainant has responded to the first reply. The handling of
the complaint is in progress. |
Notification
of Summons and Prosecutions Received |
0 |
- |
- |
- |
Reporting Changes
6. There were no reporting changes during the reporting month.
Future Key Issues
7. The key works or activities will be anticipated in the coming two months are as follows:
Party |
Role |
Contact Person |
Phone No. |
AMMJV |
Engineer
Representative |
Mr. Tommy
Wong |
3695 0419 |
Cinotech |
Environmental
Team |
Ms.
Betty Choi |
2151 2072 |
ERM |
Independent
Environmental Checker |
Ms.
Mandy To |
2271 3113 |
GCL |
Contractor |
Mr. Sampson
Lo |
9752 9118 |
Permit / License No. |
Valid Period |
Status |
|
From |
To |
||
Environmental Permit (EP) |
|||
EP-457/2013/D |
15
Jun 2021 |
N/A |
Valid |
Notification of Construction Works under
Air Pollution Control Ordinance (APCO) |
|||
457345 |
19
Jun 2020 |
End
of Project |
Valid |
Billing Account for Construction Waste
Disposal |
|||
7037679 |
26
Jun 2020 |
N/A |
Valid |
Registration of Chemical Waste Producer –
Ho Man Tin |
|||
5213-236-G2347-61 |
28
Nov 2023 |
N/A |
Valid |
Wastewater Discharge Licence - Ho Man Tin |
|||
WT10002215-2023 |
2
Feb 2024 |
31
Jan 2029 |
Valid |
Construction Noise Permit - Ho Man Tin |
|||
GW-RE0016-24 |
14
Jan 2024 |
13
Apr 2024 |
Valid |
Monitoring Stations |
Locations |
Location of Measurement |
M-A3 |
S.K.H. Tsoi Kung Po
Secondary School |
Rooftop
(about 3/F) Area |
Equipment |
Model and Make |
Serial No. |
Quantity |
Calibrator |
TISCH TE-5025A |
3864 |
1 |
1-hour TSP Dust Meter |
Dust Monitor System OC-9200 |
OC20210316224101 |
1 |
High Volume Sampler |
TE-5170 c/w of TSP sampling inlet |
2204 |
1 |
Wind Anemometer |
C-OC-9200-wind |
OC20210316224101 |
1 |
Parameters |
Frequency |
1-hour TSP |
Three times / 6 days |
24-hour TSP |
Once / 6 days |
Monitoring Stations |
Locations |
Location of Measurement |
M-N3 |
S.K.H. Tsoi Kung Po
Secondary School |
Rooftop
(about 3/F) Area |
Equipment |
Model and Make |
Serial No. |
Quantity |
Sound Calibrator |
SOUNDTEK ST-120 |
181001637 |
1 |
Hangzhou Aihua Instruments Co., Ltd. AWA6021A |
1023253, 1023064 |
2 |
|
Integrating Sound Level Meter |
SVANTEK SVAN 979 |
27189 |
1 |
BSWA Technology BSWA 308 |
570187, 580156 |
2 |
Monitoring Stations |
Parameter |
Period |
Frequency |
Measurement |
M-N3 |
L10(30 min.) dB(A) L90(30 min.) dB(A) Leq(30 min.) dB(A) |
0700-1900 hrs on normal weekdays |
Once per week |
Façade |
Monitoring
Stations |
Baseline Noise Level, dB (A) |
Noise
Limit Level, dB (A) |
M-N3 |
67.7(1) (at 0700 –
1900 hrs on normal weekdays) |
70(*) (at 0700 –
1900 hrs on normal
weekdays) |
(*) Noise Limit Level is 65 dB(A) during school
examination periods.
Note (1): The noise level due to the construction
work (CNL) was calculated by the following formula:
CNL = 10 log
(10MNL/10 – 10BNL/10)
Remarks: MNL =
Measured Noise Level, BNL = Baseline
Noise Level
Quantity |
|||||||
|
Inert C&D Materials |
Non-inert C&D Materials |
|||||
Reporting
Period |
Total
Quantity Generated (in
'000m3) |
Disposed
as Public
Fill (in '000m3) |
Others,
e.g. general
refuse (in '000m3) |
Metals (in
'000kg) |
Paper/cardboard Packaging (in
'000kg) |
Plastics (in
'000kg) |
Chemical
waste (in '000kg) |
January 2024 |
0 |
0 |
0.294 |
0 |
0 |
0 |
0 |
Parameters |
Date |
Observations |
Follow-up
Actions |
Water Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Air Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Noise |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Waste / Chemical
Management |
7 Feb 2024 |
Drip tray should be provided for chemicals and oils. |
Chemicals and oils have
been removed |
Land
Contamination |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Landscape and Visual |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Permits /Licences |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
EP Condition (EP-457/2013/D) |
Submission |
Submission Date |
Condition
3.4 |
Monthly
EM&A Report (January 2024) |
14 February 2024 |
I. Introduction
This is the 54th Monthly EM&A Report prepared by
Fugro Technical Services Limited for the Contract No. HY/2018/08 Central
Kowloon Route – Central Tunnel. The Contract No. HY/2018/08 commenced on 19
September 2019. This report summarized the monitoring results and audits
findings of the EM&A programme under the issued EP (EP No.: EP-457/2013/D)
and in accordance with the EM&A Manual during the reporting period from
01/02/2024 to 29/02/2024.
II. Summary of Main Works
Undertaken and Key Measures Implemented
The main construction works carried out in the
reporting period were as follow:
Ho Man Tin1
· Underbreak scaling and
smoothing works;
· Invert, lining and OHVD
construction;
· Road improvement and
re-surfacing work.
Yau Ma Tei
· Underbreak scaling and smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD
construction;
· Mucking out from tunnel;
· Road slab and invert slab
construction;
· Waterproofing work;
· Extension of Noise Enclosure;
· Cut and cover construction.
Ma Tau Kok
· Underbreak scaling and
smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD
construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Cut and cover construction.
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Concreting.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man Tin site surface was
substantially completed. The site had been handed over to Contract No.
HY/2019/13 on 30 December 2023.
III. Summary of Exceedances,
Investigation and Follow-up
The last impact monitoring conducted by ET of Contract HY/2018/08 at
M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was
subsequently conducted by Environmental Team of Contract HY/2019/13 since
January 2024. The monitoring results at M-A3 and M-N3 are presented in the
monthly EM&A Report prepared by Contract No. HY/2019/13.
No Action and Limit Level exceedance was recorded for construction dust
monitoring in the reporting month.
Four (4) Action Level exceedance was recorded for construction noise due
to the noise-related complaints received in the reporting month. No Limit Level
exceedance was recorded for construction noise monitoring in the reporting
month.
IV. Complaint Handling,
Prosecution and Public Engagement.
All complaints received in
the last reporting month were finalized.
Four (4) noise-related
complaint (i.e. 17th, 20th 26th and
28th February 2024) were received in the reporting month.
The complaint cases in February 2024 are summarized in Table I.
Table I Environmental Complaints
Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
17th February
2024 |
The Contractor Hotline |
Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
|
EC185_CKRCT20240220_767 |
20th February
2024 |
1823 |
Daytime and Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
EC186_CKRCT20240226_768 |
26th February
2024 |
1823 |
Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
EC187_CKRCT20240228_769 |
28th February
2024 |
The Contractor Hotline |
Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
No notification of summons and prosecutions were
received in the reporting period.
No public engagement activities were conducted in
the reporting period.
V. Reporting Change
There were no reporting changes during the
reporting month.
VI. Future Key Issues
The main works will be anticipated in the next
reporting period are as follow:
Ho Man Tin1
· Underbreak scaling and
smoothing works;
· Invert, lining and OHVD
construction.
Yau Ma Tei
· Underbreak scaling and
smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD
construction;
· Mucking out from tunnel;
· Road slab and invert slab construction;
· Waterproofing work;
· Cut and cover construction.
Ma Tau Kok
· Underbreak scaling and
smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD
construction;
· Mucking out from tunnel;
· Road slab and invert slab
construction;
· Waterproofing work;
· Cut and cover construction
Kai Tak Barging Point
· Material storage.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man Tin site surface was
substantially completed. The site had been handed over to Contract No.
HY/2019/13 on 30 December 2023.
The recommended mitigation measures corresponding to the main works in the
next reporting period are listed as follow:
· Good relationship shall be
maintained with the nearby sensitive receivers/ stakeholders which may be
affected by the construction works such as providing better/ more detail
information of the work nature and inform in advance of the works to the nearby
residents;
· Any excavated, stockpile of
dusty material or load of dusty materials on a vehicle leaving a construction
site should be covered entirely by impervious sheeting;
· All construction plants /
machineries should be checked / serviced on a regular basis during the courses
of construction to minimize the emission of noise generation and eliminate dark
smoke emission;
· All C&D materials
generated should be transported and stored at temporary storage area. Suitable
materials should be sorted for reuse on-site;
· Every vehicle shall be
cleaned thorough at the designated wheel washing area onsite;
· Wastewater generated from
drilling shall be properly collected for reuse or treated by wastewater
treatment facilities before discharge;
· Provision of drip trays for
equipment likely cause spillage of chemical / fuel, and provide routine
maintenance;
· Erecting temporary noise
barrier for noisy Powered Mechanical Equipment (PME) and deployment of Quality
Powered Mechanical Equipment (QPME) as many as practicable;
· Conditions in the
Environmental Permit and License should be followed;
· All recommended mitigation
measures specified in the approved EIA Report and EM&A Manual shall be
implemented;
· All vehicles should be
cleaned before leaving the construction site to ensure no muddy deposited by
them on roads.
The following EP submissions were submitted during the reporting month:
Table II Status of Required Submission
under Environmental Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly
EM&A Report (January 2024) |
6 February 2024 |
Contents
1.3 Construction Programme and
Activities
1.4 Works undertaken during the
month
1.5 Status of Environmental
Licences, Notification and Permits
2 ENVIRONMENTAL MONITORING REQUIREMENTS
2.1 Construction Dust and Noise Monitoring Locations
2.2 Construction Dust Monitoring
2.3 Construction Noise Monitoring
3 ENVIRONMENTAL MONITORING RESULTS
3.1 Construction Dust Monitoring
3.2 Construction Noise Monitoring
5 ENVIRONMENTAL COMPLAINT AND NON-COMPLIANCE
5.1 Complaint Handling, Prosecution and Public Engagement
5.2 Summary of Environmental Non-Compliance
5.3 Summary of Monitoring Exceedance
8 CONCLUSION AND RECOMMENDATIONS
Tables
Table I – Environmental
Complaints Log
Table II – Status of Required Submission under
Environmental Permit
Table 1.1 – Contact
Information of Key Personnel
Table 1.2 –
Environmental Licenses, Notification and Permits Summary
Table 2.1 – Construction
Dust and Noise Monitoring Location
Table 2.2 – Construction
Noise Monitoring Parameters, Frequency and Duration
Table 4.1 – Observations
and Recommendation of Site Inspection in the Reporting Period
Table 5.1 –
Environmental Complaints Log
Table 6.1 – Status of
Required Submission under Environmental Permit
Figures
Figure 1 The Site Layout Plan of the
Contract
Figure 2.1 The Location of the
Construction Dust and Noise Monitoring Stations (Ho Man Tin)
Figure 2.2 The Location of the Construction Dust and Noise
Monitoring Stations (Ma Tau Kok)
Figure 2.3 The Location of the Construction Dust and Noise
Monitoring Stations (Yau Ma Tei)
Appendices
Appendix A Construction Programme
Appendix B Project Organization Chart
Appendix C Event and Action Plan
Appendix D Implementation Status of
Environment Mitigation Measures (Construction Phase)
1.1.1 In order to meet the traffic
demand and relieve traffic congestion on the existing east-west roads across
Central Kowloon, Central Kowloon Route (CKR) (hereinafter referred to as “the
Project”) is proposed which is a 4.7 km long dual 3-lane trunk road in Central
Kowloon linking Yau Ma Tei Interchange in West Kowloon with the road
network on Kai Tak Development and Kowloon Bay in East Kowloon.
1.1.2 The Central Kowloon Route –
Design and Construction Environmental Impact Assessment Report (Register No.:
AEIAR-171/2013) was approved with conditions by the Environmental Protection
Department (EPD) on 11 July 2013. An Environmental Permit (EP-457/2013) was
issued on 9 August 2013. A variation of EP (VEP-594/2021) was applied on 26 May
2021 and the latest EP (EP-457/2013/D) was issued by EPD on 15 June 2021.
1.1.3 Contract No. HY/2018/08
Central Kowloon Route – Central Tunnel (hereinafter referred to as “the
Contract”), is one of the contracts of CKR which included the construction of
the central tunnel, cut-and-cover tunnels at Yau Ma Tei and Ma Tau
Kok and construction of piles and diaphragm walls for Ho Man Tin ventilation
building.
1.1.4 Fugro Technical Services
Limited (FTS) was appointed by Bouygues Travaux Publics (BTP) as the
Environmental Team (ET) under the Contract no. HY/2018/08 to execute the
environmental monitoring and audit (EM&A) programme under the issued EP (EP
No.: EP-457/2013/D) and in accordance with the EM&A Manual.
1.1.5 This is the 54th Monthly
EM&A Report prepared by FTS for the Contract No. HY/2018/08 Central Kowloon
Route – Central Tunnel. The Contract No. HY/2018/08 commenced on 19 September
2019. This report summarized the monitoring results and audits findings of the
EM&A programme under the issued EP (EP No.: EP-457/2013/D) and in
accordance with the EM&A Manual during the reporting period from 01/02/2024
to 29/02/2024.
1.2.1 The Project Organization
structure is shown in Appendix
B. The key personnel contact
names and numbers are summarized in Table 1.1.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Highways Department (HyD) |
E13/CKR |
Mr. Joe Lam |
2762 3380 |
Arup-Mott MacDonald Joint Venture (AMMJV) |
Senior Resident Engineer |
Mr. Ben Poon |
3619 5967 |
ERM-Hong Kong, Limited (ERM) |
Independent Environmental Checker (IEC) |
Ms. Mandy To |
2271 3000 |
Bouygues Travaux Publics (BTP) |
Environmental Manager |
Mr.
Simon Wong |
9281
4346 |
Fugro Technical Services Limited |
ET Leader |
Mr. Calvin Leung |
3565 4441 |
1.3 Construction
Programme and Activities
1.3.1 The construction phase of
this Contract under the EP commenced in October 2019. The site layout plan of

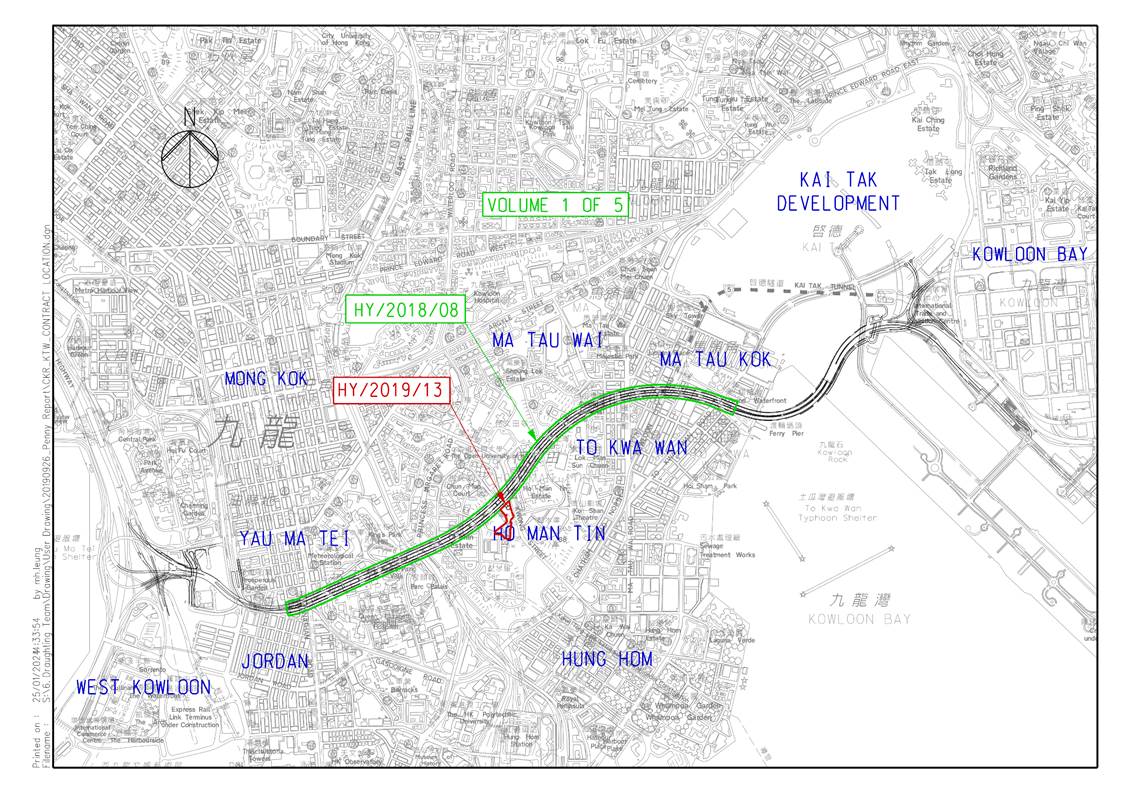

the Contract is shown in Figure 1.
1.3.2 The construction programme of
this Contract is shown in Appendix
A.
1.4 Works undertaken
during the month
1.4.1 The main construction works
carried out in the reporting period were as follow:
· Underbreak scaling and
smoothing works;
· Invert, lining and OHVD
construction;
· Road improvement and
re-surfacing work.
Yau Ma Tei
· Underbreak scaling and
smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD
construction;
· Mucking out from tunnel;
· Road slab and invert slab
construction;
· Waterproofing work;
· Extension of Noise Enclosure;
· Cut and cover construction.
Ma Tau Kok
· Underbreak scaling and
smoothing works;
· Plant and material lifting;
· Invert, lining and OHVD
construction;
· Mucking out from tunnel;
· Road slab and invert slab
construction;
· Waterproofing work;
· Cut and cover construction
Kai Tak Barging Point
· Material storage.
Sheung Lok Street
· Concreting.
Ma Hang Chung Road
· Concreting.
Note:
1 Construction Work at Ho Man Tin site surface was
substantially completed. The site had been handed over to Contract No.
HY/2019/13 on 30 December 2023.
1.5 Status of Environmental
Licences, Notification and Permits
1.5.1 A summary of the relevant
permits, licenses and/or notifications on environmental protection for this
Contract is presented in Table
1.2.
Table 1.2 Environmental
Licenses, Notification and Permits Summary
Reference No |
Valid From |
Valid Till |
|
Form NB |
448930,
448970, 448971 |
Mid-Sep
2019 |
NA |
Billing Account for
Disposal of C&D waste |
Account
no. 7034790 |
06 Aug 2019 |
NA |
Chemical Waste Producer
Registration (Ho Man Tin Construction site) |
5111-236-B2557-02 |
25 Sep 2019 |
NA |
Chemical Waste Producer
Registration (Yau Ma Tei Construction site) |
5213-225-B2557-05 |
19 Apr 2021 |
NA |
Chemical Waste Producer Registration
(Ma Tau Kok Construction site) |
5213-247-B2557-06 |
19 Apr 2021 |
NA |
Construction
Noise Permit |
|||
Construction Noise Permit (Ho Man Tin Construction
site) |
GW-RE0005-24 |
14 Jan 2024 |
13 Mar 2024 |
Construction Noise Permit (Yau Ma Tei Construction
site) |
GW-RE0015-24 |
13 Jan 2024 |
12 Apr 2024 |
Construction Noise Permit (Yau
Ma Tei Construction site)1 |
GW-RE0182-24 |
17 Feb 2024 |
16 May 2024 |
Construction Noise Permit (Yau
Ma Tei Construction site) |
GW-RE1606-23 |
23 Dec 2023 |
22 Mar 2024 |
Construction
Noise Permit (Ma Tau Kok Construction site) |
GW-RE1336-23 |
04 Nov 2023 |
03 Feb 2024 |
Construction
Noise Permit (Ma Tau Kok Construction site)2 |
GW-RE0137-24 |
9 Feb 2024 |
08 May 2024 |
Construction
Noise Permit (Ma Tau Kok Construction site) |
GW-RE1547-23 |
18 Dec 2023 |
17 Feb 2024 |
Construction
Noise Permit (Ma Tau Kok Construction site)3 |
GW-RE0171-24 |
18 Feb 2024 |
17 Aug 2024 |
Construction Noise Permit
(Kai Tak Barging Point) |
GW-RE1526-23 |
01 Dec 2023 |
29 Apr 2024 |
Construction Noise Permit
(Sheung Lok Street) |
GW-RE1422-23 |
14 Nov 2023 |
13 Mar 2024 |
Construction Noise Permit
(Fat Kwong Street TTA ) |
GW-RE0123-24 |
2 Feb 2024 |
29 Feb 2024 |
Water
Discharge License |
|||
Water Discharge License |
WT00034873-2019 (Ho
Man Tin Construction site) |
22 Nov 2019 |
30 Nov 2024 |
WT00035436-2019 (Portion 18) |
02 Apr 2020 |
30 Apr 2025 |
|
WT00037723-2021 (Yau
Ma Tei Construction site) |
07 Apr 2021 |
30 Apr 2026 |
|
WT00037883-2021 (Ma
Tau Kok Construction site) |
30 Apr 2021 |
30 Apr 2026 |
|
WT00042304-2022 (Sheung
Lok Street) |
13 Oct 2022 |
31 Oct 2027 |
|
WT10001427-20233 (Ma
Hang Chung Road) |
4 Dec 2023 |
31 Dec 2028 |
Notes:
1 GW-RE0015-24 was
superseded by GW-RE0182-24 since 17 February 2024.
2 GW-RE1336-23 was
superseded by GW-RE0137-24 since 9 February 2024.
3 GW-RE1547-23 was
superseded by GW-RE0171-24 since 18 February 2024.
2 ENVIRONMENTAL MONITORING REQUIREMENTS
2.1 Construction Dust and Noise Monitoring
Locations
2.1.1 Three construction dust monitoring locations and five construction noise
monitoring locations pertinent to the Project have been identified based on the
approved EM&A Manual for the Project. The locations of the construction
dust and noise monitoring stations are summarized in Table 2.1 as
displayed in Figures 2.1 - 2.3.
Table 2.1 Construction
Dust and Noise Monitoring Locations
Dust Monitoring Station ID |
Noise Monitoring Station ID |
Monitoring Location |
M-A3 |
M-N3 |
SKH Tsoi Kung Po Secondary
School |
/ |
E-N12a |
19 Hing Yan Street |
E-A14a |
E-N21a |
Block B of Merit Industrial
Centre |
W-A6 |
/ |
Man Cheong building |
/ |
W-N18 |
Hydan Place |
/ |
W-N25A |
Prosperous Garden Block 1 |
Notes:
1. The dust and noise monitoring stations proposed
in the EM&A Manual for M-A6/ M-N6 (i.e. Ko Fai House, Kwun
Fai Court) was not available for impact dust and noise monitoring, therefore
impact monitoring was conducted at M-A3/ M-N3 as an alternative which was
agreed by the ER, IEC and EPD;
2. The noise monitoring station proposed in the
EM&A Manual for E-N12 (i.e. Grand Waterfront Tower 3) was not available for
impact dust and noise monitoring, therefore impact monitoring was conducted at
E-N12a as an alternative which was agreed by the ER, IEC and EPD;
3. The dust and noise monitoring stations proposed
in the EM&A Manual for E-A14 (i.e. Wyler Gardens) and E-N21 (i.e Hang Chien Court Block J) was not available for
impact dust and noise monitoring, therefore impact monitoring was conducted at
E-A14a/ E-N21a as an alternative which was agreed by the ER, IEC and EPD;
4. The dust monitoring stations proposed in the
EM&A Manual for W-A5 (i.e. The Coronation) was not available for impact
dust monitoring, therefore impact monitoring was conducted at W-A6 as an
alternative which was agreed by the ER, IEC and EPD.
2.1.2 The last impact monitoring conducted by ET of Contract HY/2018/08 at
M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was subsequently
conducted by Environmental Team of Contract HY/2019/13 since January 2024 (Figure 2.1).
2.1.3 The construction dust and
noise monitoring locations at M-A3 and M-N3 are covered by Contract No.
HY/2019/13 Central Kowloon Route – Buildings, Electrical and Mechanical Works.
The monitoring results at M-A3 and M-N3 are presented in the monthly EM&A
Report prepared by Contract No. HY/2019/13.
2.1.4 The construction dust
and noise monitoring locations at E-A14a, E-N12a and E-N21a are now covered by
Contract No. HY/2014/07 Central Kowloon Route – Kai Tak West. The monitoring
results at E-A14a, E-N12a and E-N21a in the reporting month are presented in
the monthly EM&A Report prepared by Contract No. HY/2014/07.
2.1.5 The construction dust and
noise monitoring locations at W-A6, W-N18 and W-N25A are now covered by
Contract No. HY/2014/08 Central Kowloon Route –Yau Ma Tei East. The
monitoring results at W-A6, W-N18 and W-N25A in the reporting month are presented
in the monthly EM&A Report prepared by Contract No. HY/2014/08.
2.2 Construction Dust Monitoring
Monitoring Requirement
2.2.1 In accordance with the
approved EM&A Manual, 1-hour and 24-hour Total Suspended Particulates (TSP)
levels should be measured at the designated air quality monitoring stations to
indicate the impacts of construction dust on air quality. Regular Impact
24-hour TSP monitoring should be carried out for at least once every 6 days,
and 1-hour TSP monitoring should be done at least 3 times every 6 days when the
highest dust impact occurs.
Monitoring Equipment
2.2.2 24-hour TSP air quality
monitoring was performed using High Volume Sampler (HVS) deployed at the
designated monitoring station. The HVS shall meet all the requirements of the
EM&A Manual.
2.2.3 A portable direct reading
dust meter was used to carry out the 1-hour TSP monitoring.
2.3 Construction Noise Monitoring
Monitoring Requirement
2.3.1 In accordance with the
EM&A Manual, impact noise monitoring should be conducted at the designated
noise monitoring stations for at least once a week during the construction
phase of the Project. The parameters, frequency and duration of impact noise
monitoring is summarized in Table 2.2.
Table 2.2 Construction
Noise Monitoring Parameters, Frequency and Duration
Parameter |
Duration |
Frequency |
A-weighted equivalent
continuous sound pressure level (Leq). L10 and L90 were also recorded |
30 minutes |
At least once per week |
Monitoring Equipment
2.3.2 Noise monitoring was
performed using sound level meter at the designated monitoring station. The
sound level meters deployed comply with the International Electrotechnical
Commission Publications 651:1979 (Type 1) and 804:1985 (Type 1) specifications.
Acoustic calibrator was deployed to check the sound level meters at a known
sound pressure level.
2.4.1 As per the EM&A Manual,
the landscape and visual mitigation measures shall be implemented and site
inspections should be undertaken once every two weeks during the construction
period. A summary of the implementation status is presented in Section
4.
3 ENVIRONMENTAL MONITORING RESULTS
3.1 Construction Dust Monitoring
3.1.1 The last impact monitoring conducted by ET of Contract HY/2018/08 was on
27 December 2023. Impact monitoring at M-A3 was subsequently conducted by
Environmental Team of Contract HY/2019/13 since January 2024. The monitoring
results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared
by Contract No. HY/2019/13.
3.1.2 No Action and Limit Level
exceedance was recorded for construction dust monitoring in the reporting
month.
3.2 Construction Noise Monitoring
3.2.1 The last impact monitoring
conducted by ET of Contract HY/2018/08 was on 27 December 2023. Impact
monitoring at M-N3 was subsequently conducted by Environmental Team of Contract
HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented
in the monthly EM&A Report prepared by Contract No. HY/2019/13.
3.2.2 Four (4) Action Level
exceedance was recorded for construction noise due to the noise-related
complaints received in the reporting month. No Limit Level exceedance was
recorded for construction noise monitoring in the reporting month.
3.3.1 Auditing of waste management practices during regular site inspections
confirmed that the waste generated during construction were properly, stored,
handled and disposed of in general. The Contractor was
responsible for the implementation of any mitigation measures to reduce waste
or redress issues arising from the waste materials.
3.3.2 The implemented environmental
mitigation measures for the waste management in the reporting period are
summarized in Appendix
D. The summary of observations
and recommendations made for waste management during the site inspections are
presented in Table 4.1.
3.3.3 Monthly summary of waste flow
table is detailed in Appendix
F.
3.4.1 Bi-weekly inspections of the
implementation of landscape and visual mitigation measures were conducted on 14
and 27 February 2024. The implementation the landscape and visual mitigation
measures in the reporting period are summarized in Appendix D. The summary of observations and recommendations
made for landscape and visual mitigation measures during the site inspections
are presented in Table 4.1.
3.4.2 The Event and Action Plan for
landscape and visual during construction phase is given in Appendix C.
4 ENVIRONMENTAL SITE INSPECTION AND AUDIT
4.1.1 Site inspections were carried
out on a weekly basis to monitor the implementation of proper environmental
pollution control and mitigation measures for the Project. A summary of the
mitigation measures implementation status is provided in Appendix D.
4.1.2 In the reporting month, five
site inspections were carried out on 6 (with IEC), 14, 20 and 27 February 2024.
Details of observations recorded during the site inspections are presented
in Table 4.1.
Environmental Aspect |
Date |
Observations, Reminders,
and Recommendations |
Follow-up Actions |
Air Quality |
14 February 2024 |
Contractor was reminded to carry out water
spraying regularly to prevent spreading of dust. |
Nil |
Noise |
Nil |
Nil |
Nil |
Water Quality |
6 February 2024 |
Contractor was reminded to request maintenance
for the monitor showing pH value of wastewater treatment plant and ensure the
wastewater treatment plant to work properly while pending for maintenance. |
Contractor has contacted supplier and the
wastewater treatment plant is pending for maintenance. |
Waste Management |
14 February 2024 |
Contractor was reminded to collect and remove
general waste from the site regularly. |
Nil |
Landscape and Visual |
Nil |
Nil |
Nil |
Permit/ Licenses |
Nil |
Nil |
Nil |
5 ENVIRONMENTAL COMPLAINT AND NON-COMPLIANCE
5.1 Complaint Handling, Prosecution
and Public Engagement
5.1.1 All complaints received in
the last reporting month were finalized.
5.1.2 Four (4) noise-related
complaint (i.e. 17th, 20th 26th and
28th February 2024) were received in the reporting month.
5.1.3 The complaint cases in
February 2024 are summarized in Table 5.1.
Table 5.1 Environmental
Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
EC184_CKRCT20240217_766 |
17th February
2024 |
The Contractor Hotline |
Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
EC185_CKRCT20240220_767 |
20rd February
2024 |
1823 |
Daytime and Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
EC186_CKRCT20240226_768 |
26th February
2024 |
1823 |
Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
EC187_CKRCT20240228_769 |
28th February
2024 |
The Contractor Hotline |
Nighttime Noise |
Under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. |
5.1.4 Cumulative complaint log,
summaries of complaints, notification of summons and successful prosecutions
are presented in Appendix
E.
5.1.5 No public engagement
activities were conducted in the reporting period.
5.2 Summary of Environmental Non-Compliance
5.2.1 No environmental
non-compliance was recorded in the reporting period.
5.3 Summary of Monitoring Exceedance
5.3.1 The last impact monitoring
conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023.
Impact monitoring at M-A3/ M-N3 was subsequently conducted by Environmental
Team of Contract HY/2019/13 since January 2024. The
monitoring results at M-A3 and M-N3 are presented in the monthly EM&A
Report prepared by Contract No. HY/2019/13.
5.3.2 No Action and Limit Level
exceedance was recorded for construction dust monitoring in the reporting
month.
5.3.3 Four (4) Action Level
exceedance was recorded for construction noise due to the noise-related
complaints received in the reporting month. No Limit Level exceedance was
recorded for construction noise monitoring in the reporting month.
6 IMPLEMENTATION STATUS OF ENVIRONMENTAL MITIGATION
MEASURE
6.1.1 The Contractor had
implemented environmental mitigation measures and requirements as stated in the
EIA Report, the EP and EM&A Manual. The implementation status of the
environmental mitigation measures during the reporting period is summarized
in Appendix D. Status of required submissions under the EP during
the reporting period is summarised in Table 6.1.
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly
EM&A Report (January 2024) |
6 February 2024 |
7.1.1 The main works will be
anticipated in the next reporting period are as follow:
Ho Man Tin1
Underbreak scaling and
smoothing works;
Invert, lining and OHVD
construction.
Yau Ma Tei
Underbreak scaling and
smoothing works;
Plant and material lifting;
Invert, lining and OHVD
construction;
Mucking out from tunnel;
Road slab and invert slab
construction;
Waterproofing work;
Cut and cover construction.
Ma Tau Kok
Underbreak scaling and
smoothing works;
Plant and material lifting;
Invert, lining and OHVD
construction;
Mucking out from tunnel;
Road slab and invert slab
construction;
Waterproofing work;
Cut and cover construction
Kai Tak Barging Point
Material storage.
Ma Hang Chung Road
Concreting.
Note:
1 Construction
Work at Ho Man Tin site surface was substantially completed. The site had been
handed over to Contract No. HY/2019/13 on 30 December 2023.
7.1.2 The recommended mitigation
measures corresponding to the main works in the next reporting period are
listed as follows:
Good relationship shall be
maintained with the nearby sensitive receivers/ stakeholders which may be
affected by the construction works such as providing better/ more detail
information of the work nature and inform in advance of the works to the nearby
residents;
Any excavated, stockpile of
dusty material or load of dusty materials on a vehicle leaving a construction
site should be covered entirely by impervious sheeting;
All construction plants /
machineries should be checked / serviced on a regular basis during the courses
of construction to minimize the emission of noise generation and eliminate dark
smoke emission;
All C&D materials
generated should be transported and stored at temporary storage area. Suitable
materials should be sorted for reuse on-site;
Every vehicle shall be
cleaned thorough at the designated wheel washing area onsite;
Wastewater generated from
drilling shall be properly collected for reuse or treated by wastewater
treatment facilities before discharge;
Provision of drip trays for
equipment likely cause spillage of chemical / fuel, and provide routine
maintenance;
Erecting temporary noise
barrier for noisy Powered Mechanical Equipment (PME) and deployment of Quality
Powered Mechanical Equipment (QPME) as many as practicable;
Conditions in the
Environmental Permit and License should be followed;
All recommended mitigation
measures specified in the approved EIA Report and EM&A Manual shall be
implemented.
All vehicles should be
cleaned before leaving the construction site to ensure no muddy deposited by
them on roads.
8 CONCLUSION AND RECOMMENDATIONS
8.1.1 The 54th Monthly
EM&A Report for the Contract No. HY/2018/08 Central Kowloon Route – Central
Tunnel summarized the monitoring results and audits findings of the EM&A
programme under the issued EP (EP No.: EP-457/2013/D) and in accordance with
the EM&A Manual during the reporting period from 01/02/2024 to 29/02/2024.
8.1.2 No construction noise monitoring was conducted in the reporting month as
the site had been handed over to Contract No. HY/2019/13 on 30 December 2023.
Impact monitoring at M-A3/ M-N3 has been conducted by Environmental Team
(HY/2019/13) since January 2024.
8.1.3 Four (4) Action Level
exceedance was recorded for construction noise due to the noise-related
complaints received in the reporting month. No Limit Level exceedance was
recorded for construction noise monitoring in the reporting month. No Action
and Limit Level exceedance was recorded for construction dust monitoring in the
reporting month.
8.1.4 Weekly environmental site
inspections were conducted during the reporting period. In general, the
Contractor had implemented environmental mitigation measures and requirements
as stated in the EIA Report, the EP and EM&A Manual.
8.1.5 All complaints received in
the last reporting month were finalized.
8.1.6 Four (4) noise-related
complaint (i.e. 17th, 20th, 26th and 28th February
2024) were received in the reporting month. All complaints are under
investigation and will be reported in the subsequent reporting month.
8.1.7 No environmental related
prosecutions or notification of summons were received in the reporting period.
8.1.8 No environmental
non-compliance was recorded in the reporting period.
8.1.9 According to the
environmental site inspections performed in the reporting month, the following
recommendations were provided:
Contractor was reminded to
carry out water spraying regularly to prevent spreading of dust on 14th February
2024.
No specific observation was
identified in the reporting month.
Contractor was reminded to
request maintenance for the monitor showing pH value of wastewater treatment
plant and ensure the wastewater treatment plant to work properly while pending
for maintenance on 6th February 2024. Contractor has contacted supplier and the
wastewater treatment plant is pending for maintenance.
Contractor was reminded to
collect and remove general waste from the site regularly on 14th February
2024.
No specific observation was
identified in the reporting month.
No specific observation was
identified in the reporting month.
